Shared ESS
Shared ESS — Grid Flexibility Resource
A new ESS business model that connects large-scale energy storage to the distribution grid at a single site, enabling multiple remote consumers to benefit from electricity cost savings through virtual net metering while providing grid stabilization when needed.

The Seoul metropolitan area (Gyeonggi Province) faces insufficient power supply relative to high electricity demand, and grid expansion is difficult due to public acceptance issues. Demand-side ESS deployment has stalled due to lack of policies and low economic viability.
Gyeonggi Yongin cluster alone forecasts 14.7GW demand by 2053. National peak demand expected to reach 202.0GW by 2051
Major transmission line construction delayed 66–150 months due to public acceptance issues
New installation market disappeared after special rate expiration in 2019. Utilization of existing ESS also remains low
According to the 10th Basic Plan for Electricity Supply and Demand, the required capacity for peak shaving ESS to reduce metropolitan area peak power demand is projected to increase continuously.
| 2024 | 2028 | 2029 | 2030 | 2036 |
|---|---|---|---|---|
| 126MW | 440MW | 559MW | 699MW | 2,100MW |
* Source: 10th Basic Plan for Electricity Supply and Demand
A new ESS business model that connects large-scale energy storage to the distribution grid at a single site, enabling multiple remote consumers to receive electricity cost savings through virtual net metering while providing grid stabilization as needed
Provides power resources when distribution grid stabilization is needed
Fire prevention and reduced operating costs through professional operator management
Participation in various revenue markets including virtual net metering, NWAs benefits, and VPP
| Category | Individual Building ESS | Shared ESS |
|---|---|---|
| Installation location | Inside building | Outside building, near distribution lines |
| Initial investment | High — individual building batteries and construction costs | Low — bulk battery purchase and single-site construction |
| Revenue generation | Low — only basic rate and energy savings | High — rate savings + flexibility provision during line overload |
| Payback period | ~27 years (100kWh basis: ₩100M investment, ₩3.7M annual revenue) | ~13 years (100kWh basis: ₩65M investment, ₩6.11M annual revenue) |
| O&M | On-site staff management, difficult without experts | Professional ESS operator maintenance, cost reduction and expertise |
| Future BM | Difficult to expand | DR, VPP, stored electricity sales and more |
A compensation system that pays operators who provide technology to replace or defer new distribution line construction under short-term, intermittent conditions, covering costs for the period the line construction was avoided or delayed.
Customers benefit from electricity cost savings without owning ESS equipment — charge/discharge power from ESS installed at a third-party site is allocated and offset by time period, providing equivalent rate reduction effects.
Shared ESS Construction and Virtual Net Metering Transaction Demonstration for Metropolitan Distribution Grid Flexibility
Participants: Goyang Urban Management Corp. (57%), Ninewatt (43%)
H/W 구축
ESS 0.25MW/1MWh + ESS 1MW/4MWh construction
S/W 구축
ESS optimal operation algorithm development, virtual net metering settlement system development
A public-private integrated demonstration alliance has been formed to verify the entire process of shared ESS technology, regulation, and operation.

Lead local government
Lead local government
Grid operator
Shared ESS equity investor
Technical advisory
Project lead
Gyeonggi Province and Goyang Special City launched the Shared ESS project in September 2024, establishing plans to build two Shared ESS sites (1MWh and 4MWh).
Shared ESS business model planning and launch of local government collaboration
Demand survey for Shared ESS participation across provincial cities and budget planning
Formation of public-private consortium and completion of feasibility review
Selected for MOTIE competitive grant, securing additional national funding for 4MWh ESS

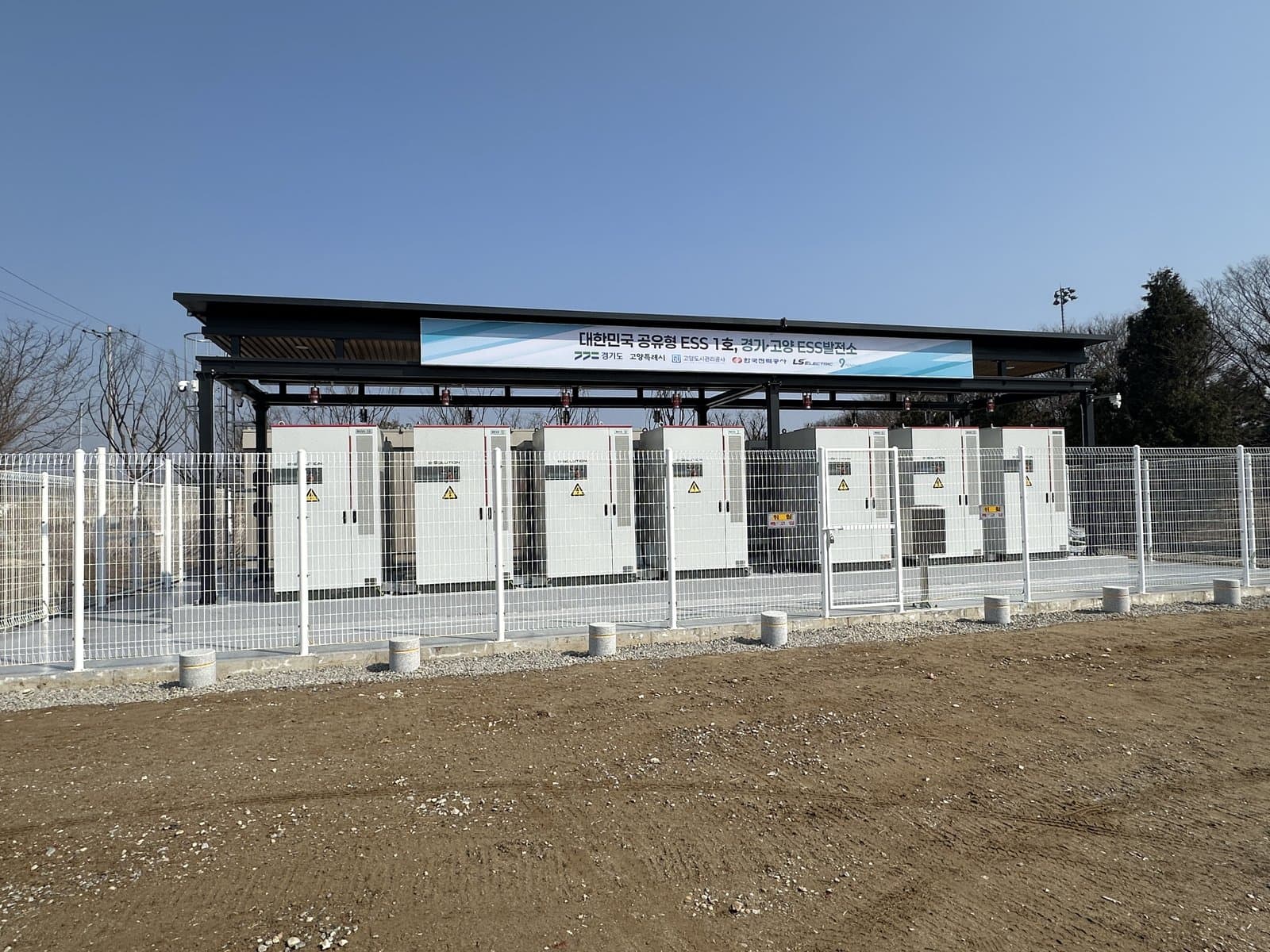

ESS installation site selected and construction commenced
Pre-emptively secured provincial and city funding for 1MWh ESS construction, then strategically attracted additional national funding from MOTIE for 4MWh ESS expansion.
Provincial Subsidy
Competitive Grant
~40%
Initial investment cost reduction
13 yrs
Payback period (half of individual ESS)
5MWh
Phase 1 ESS installation scale
Phase 1 ('25)
Phase 2 ('26)
141MWh (~₩70B)
Phase 3 ('27~)
6,300MWh (~₩3T)
We provide detailed consultation on shared ESS construction and virtual net metering transaction demonstration.
